Pot Line 6 Secondary Bath Crushing Plant Project for Outotec/ALBA

Project Background:

In order to achieve the annual production capacity from 1 to 1.5 million tons of aluminum, Alba is installing fully equipped Anode Rodding shops as well as Baths/Butts Recycling facilities. As part of these expansions MCSC was to construct the Secondary Bath Crushing Plant Project, OUTOTEC was the EPC Contractor. The Project execution started in Nov 2020 and completed by June 2021.

Project Scope & Highlights:

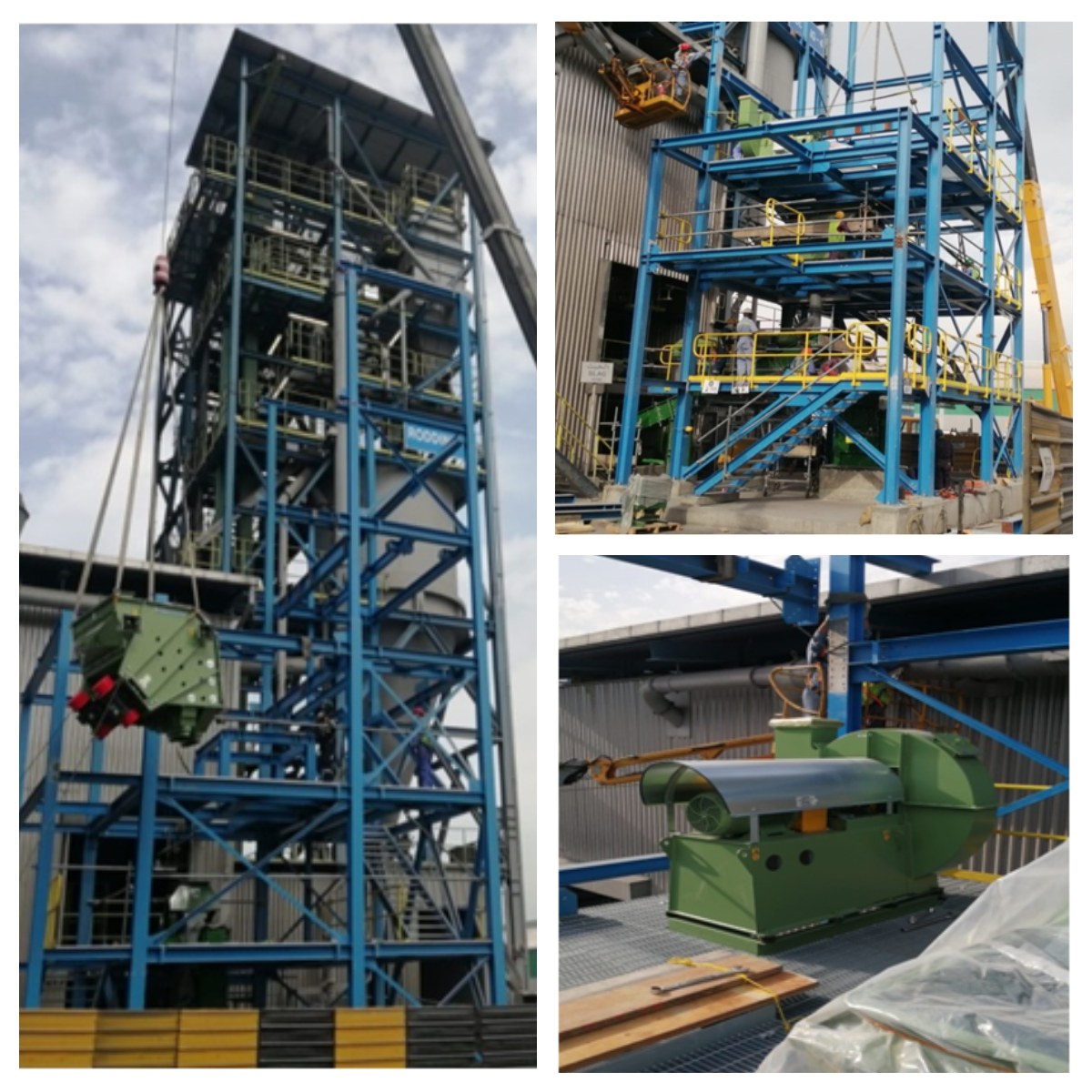

Project scope includes Civil, Fabrication & Installation of Structural Steel, Fabrication & Installation of Compressed Air Piping, Installation & Alignment of Equipment, Fabrication & Installation of Ducts and Chutes, Installation of Electrical & Instrumentation works, Tie-in works, Painting and Pre-commissioning & Commissioning Assistance.

  • Project Duration: 7 Months (Nov. 2020 to June 2021)
  • Man-hours: 67,564 Hours, without LTI.
  • Excavation Works: 70 Cu. M.
  • Concrete Works: 96 Cu. M.
  • Rebar Works: 10 Ton
  • Compressed Air Piping: 173 Inch. Dia.
  • Duct & Chute Works: 10.5 Ton
  • Structural Steel Fabricated & Erected: 38 Tons.
  • Equipments Erected: 11 Nos (30 Ton)
  • Manual Hoist (2.5T) : 2 Nos
  • Cable Tray Installation: 323 M
  • Electrical Cable Laid: 4,695 M
  • Instrument Cable Laid: 3,850 M
