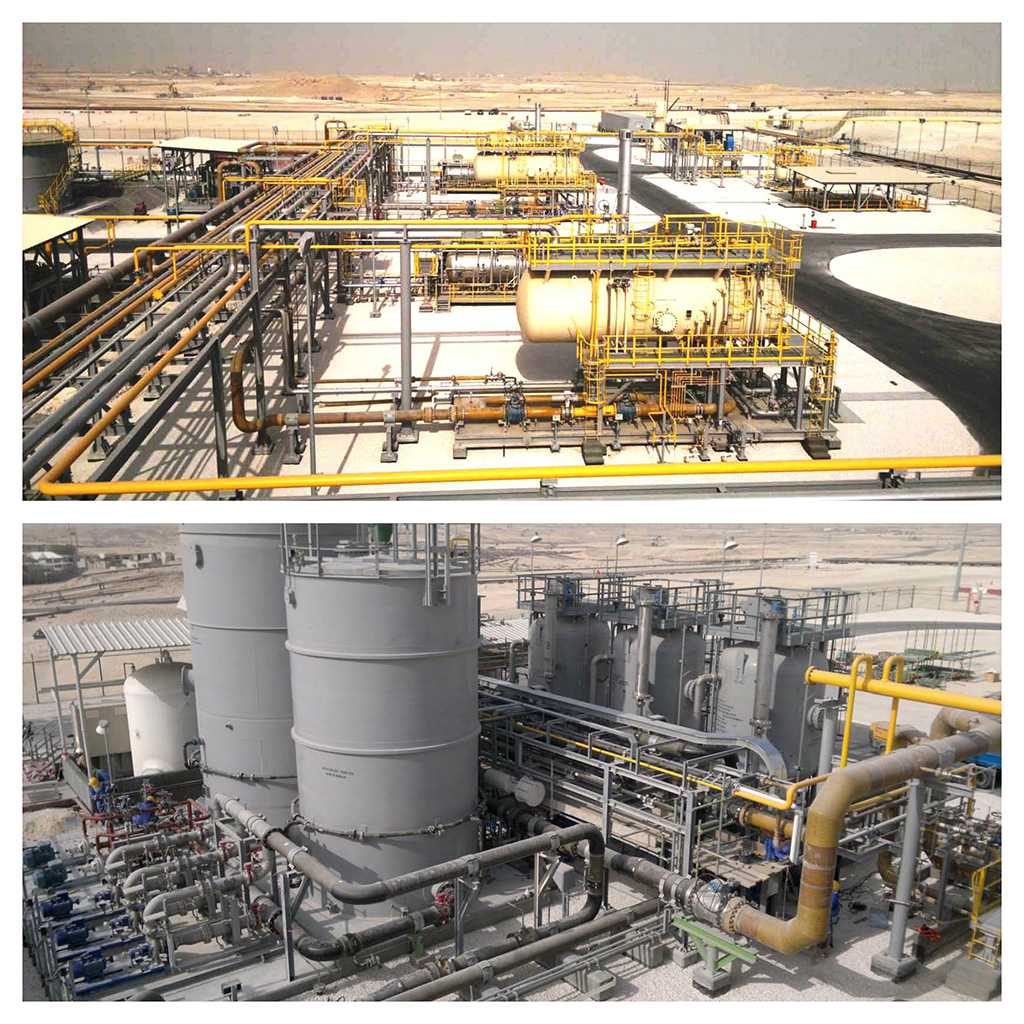

New Tank Battery Facilities EPC Project for Tatweer Petroleum

Project Background:

As part of the Bahrain Awali field development new drilling programme, Tatweer Petroleum awarded to MCSC the EPC contract for building two identical tank batteries. To process the increased light oil production, each tank battery unit has a set of common facilities serving separation trains with provision for a third separation train to be added in future. Each tank battery separation train is designed to handle an oil flow rate of 10,800 bbl/day, a produced water flow rate of 69,500 bbl/day and 1% of total liquid volume for residual gas.

Project Scope & Highlights:

Project scope included EPC of civil, mechanical, piping construction, equipment erection, painting, electrical, instrumentation, pre‐commissioning & commissioning assistance works of new tank battery facilities TB07 & TB08.

  • Duration: 24 Months (Oct 2011 ‐Sep 2013).
  • Man Hours: 1,742,500, (without LTI ).
  • Concrete Works: 5,000 Cu.M.
  • Excavation Works: 15,095 Cu.M.
  • Rebar Works: 393 Ton.
  • Asphalt & Paving Works: 25,179 Sq. M.
  • GRE Piping Welding: 49,688 Inch Dia.
  • Carbon Steel Piping Welding: 41,800 Inch Dia.
  • No. of packs Hydro tested: 460.
  • No. of Joints RT Tested: 1,420.
  • Structural Steel Fabricated & Erected: 538 Tons.
  • Pumps erected: 26 Nos.
  • Equipment/Vessels: 26 Nos.
  • Flare Stack of 25m height: 02 Nos.
  • Water Treatment Package: 04 Nos.
  • Total E&I Cable Layed: 251,706 m.
  • Total Loop Checks: 1,382 Nos.
  • Room (LERs): 02 Nos.
